Case Study of Kaifeng Qingming Shanghe Garden Main Beam Deviation Monitoring Project

As a professional provider of IoT data acquisition solutions and an expert in industrial IoT data acquisition, the editor of Shanghai Data Acquisition IOT Technology Co., Ltd, (daq-iot) hereby presents the following introduction, and sincerely welcomes discussions and exchanges. Supported Communication Interfaces: CAN, RS485, Mbus, 4–20mA, Profibus, CC-Link, HART, digital I/O, etc. Industrial Protocols: Modbus RTU/TCP, HJ212, IEC104, DLT645, DLMS, IEC61850, MQTT, etc. Mail:export@daq-iot.com

Project Background

Riverside Scene at Qingming FestivalThe scenic area is located in Kaifeng, the ancient capital of eight dynasties. It is a large-scale Song Dynasty historical and cultural theme park that has been restored 1:1 based on the famous Chinese painting "Along the River during Qingming Festival". Kaifeng has achieved historical success, and the famous garden has achieved cultural success.
Since its official opening to the outside world in 1998, Qingming Shanghe Garden has always adhered to the development policy of "reproducing the millennium historical picture and building a national boutique scenic spot". Through its grand scale, rich cultural connotations of the Song Dynasty, unique ancient entertainment facilities, innovative performance plays, and new leisure vacation concepts,
Always leading the development direction of the Central Plains cultural tourism industry, creating the acclaimed "Qingming Riverside Garden" phenomenon in the tourism industry.
For more than 20 years, Qingming Shanghe Garden has won many honors such as China's well-known tourism brand, national cultural industry demonstration base, national 5A level tourist attraction, China's top ten cultural tourism attractions, China's world-renowned tourism culture brand, and Henan Provincial Governor's Quality Award.


projectDemandresearch analysis

Requirement analysis: Within the Qingming Shanghe Garden Scenic Area,Da Song School FieldThe surrounding observation deck is built in the style of Song Dynasty architecture. To ensure safety in the scenic area, it is necessary to monitor the load-bearing columns and main beams of the observation deck to prevent safety hazards caused by the displacement of the main beams. Eight points on site need to be monitored for displacement.


On site investigation and research

Project Proposal

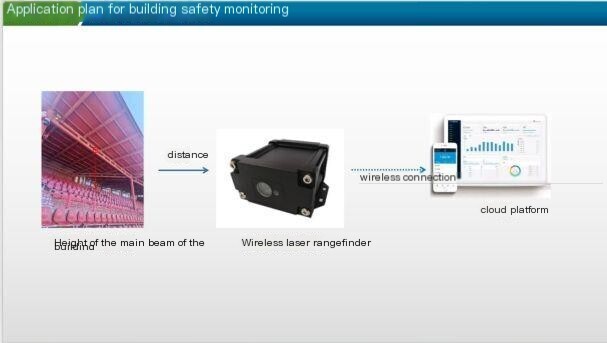

adopt4G laser rangefinderThe Hardware collection scheme indirectly monitors the deviation of the main beam by monitoring the distance between the main beam and the fixed position on the ground, which is in line with the actual cost and construction aspects.

Considering that wiring cannot be done on site, the laser rangefinder is powered by batteries. Laser rangefinders are installed at 8 points on the main beam to measure and monitor whether the main beam position has moved downwards. The collected data is transmitted to the platform via 4G to facilitate customer viewing of the data.


project implementation

1. FromIoTCompanyProvide battery powered laser rangefinders to customers.

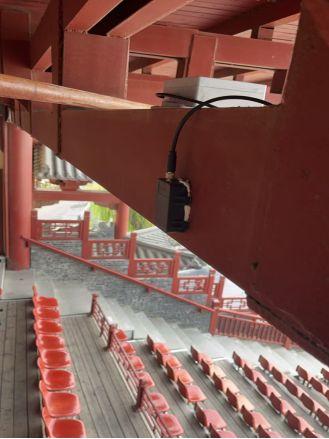

2. After receiving the equipment, the customer cooperates with our technical personnel for installation, and the technical personnel remotely configure Protocol Gateway. See the image below

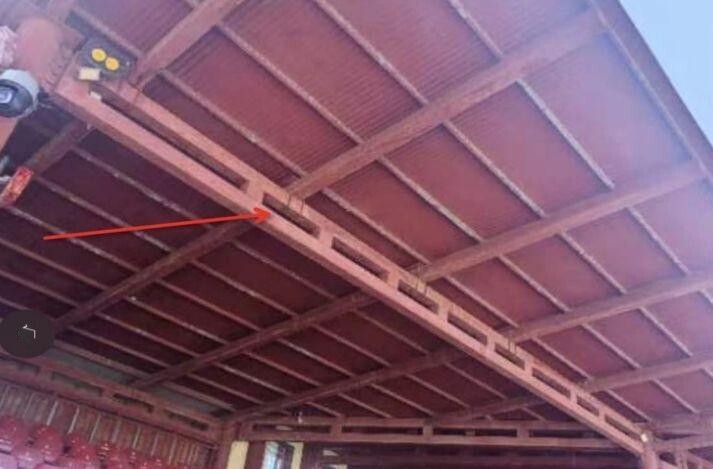

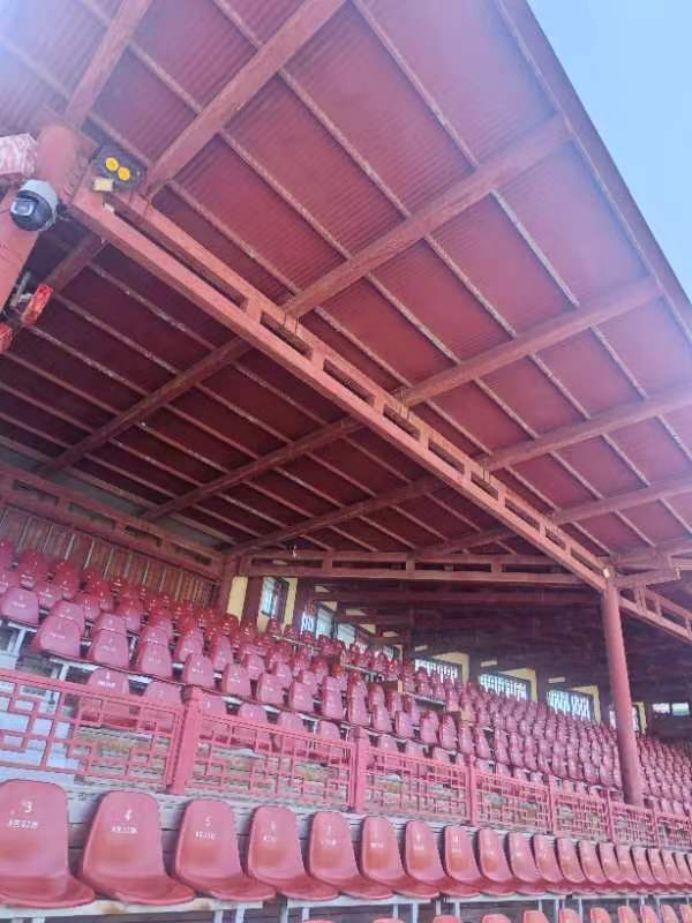

Laser rangefinder collection and installation photos

图片3 Data Display

Data display platform
